When CRM Integration Costs More Than the CRM Itself

Organizations budget CRM integrations as one-time projects but discover they operate as perpetual subscriptions. Learn why integration maintenance costs compound faster than the software itself.

Manus AI
January 5, 2026
13 min read
When CRM Integration Costs More Than the CRM Itself

# When CRM Integration Costs More Than the CRM Itself

Most organizations approach CRM procurement with a clear budget framework: per-seat licensing, implementation fees, and perhaps a line item for "integrations." A typical mid-market company might allocate fifty thousand dollars for CRM software, another twenty thousand for implementation, and fifteen thousand for integrating their marketing automation and support desk. The total—eighty-five thousand dollars—feels substantial but manageable within annual IT budgets.

Eighteen months later, that same organization discovers they've spent two hundred thirty thousand dollars. The CRM subscription renewed as expected, but integration costs metastasized in ways procurement never anticipated. Each new marketing tool required another integration. API rate limits forced an unexpected tier upgrade. A data migration that was supposed to take six weeks stretched to four months and triggered emergency consulting fees. The finance team demands explanations for budget overruns that now exceed one hundred fifty percent of the original allocation.

The core miscalculation isn't about vendor pricing transparency or hidden fees. It's about treating integration as a capital expenditure—a one-time project with a defined endpoint—when it actually operates as an operational expenditure with compounding maintenance burden. Organizations budget for the cost to build integrations but systematically underestimate the cost to sustain them. This measurement gap creates a predictable failure pattern: teams select CRM platforms based on software costs, then discover that integration complexity becomes the binding constraint on total cost of ownership.

## The Integration Maintenance Burden Nobody Budgets For

When procurement teams evaluate CRM integration costs, they focus on observable project expenses: developer hours to build the integration, middleware licensing if needed, and perhaps some testing time. A typical integration between a CRM and marketing automation platform might be estimated at fifteen thousand dollars based on two hundred hours of engineering work at seventy-five dollars per hour. This calculation treats integration as a discrete deliverable—once it's built and tested, it's done.

Industry research reveals a starkly different cost structure. Organizations maintaining three eCommerce platform integrations in-house report annual costs around ninety thousand dollars, driven primarily by qualified professionals who maintain these connections. The per-integration maintenance burden ranges from fifty thousand to one hundred fifty thousand dollars annually, depending on regional labor costs and integration complexity. For a company in Western Europe where engineering rates reach one hundred fifty dollars per hour, a single integration can consume more than one full-time equivalent just for ongoing maintenance.

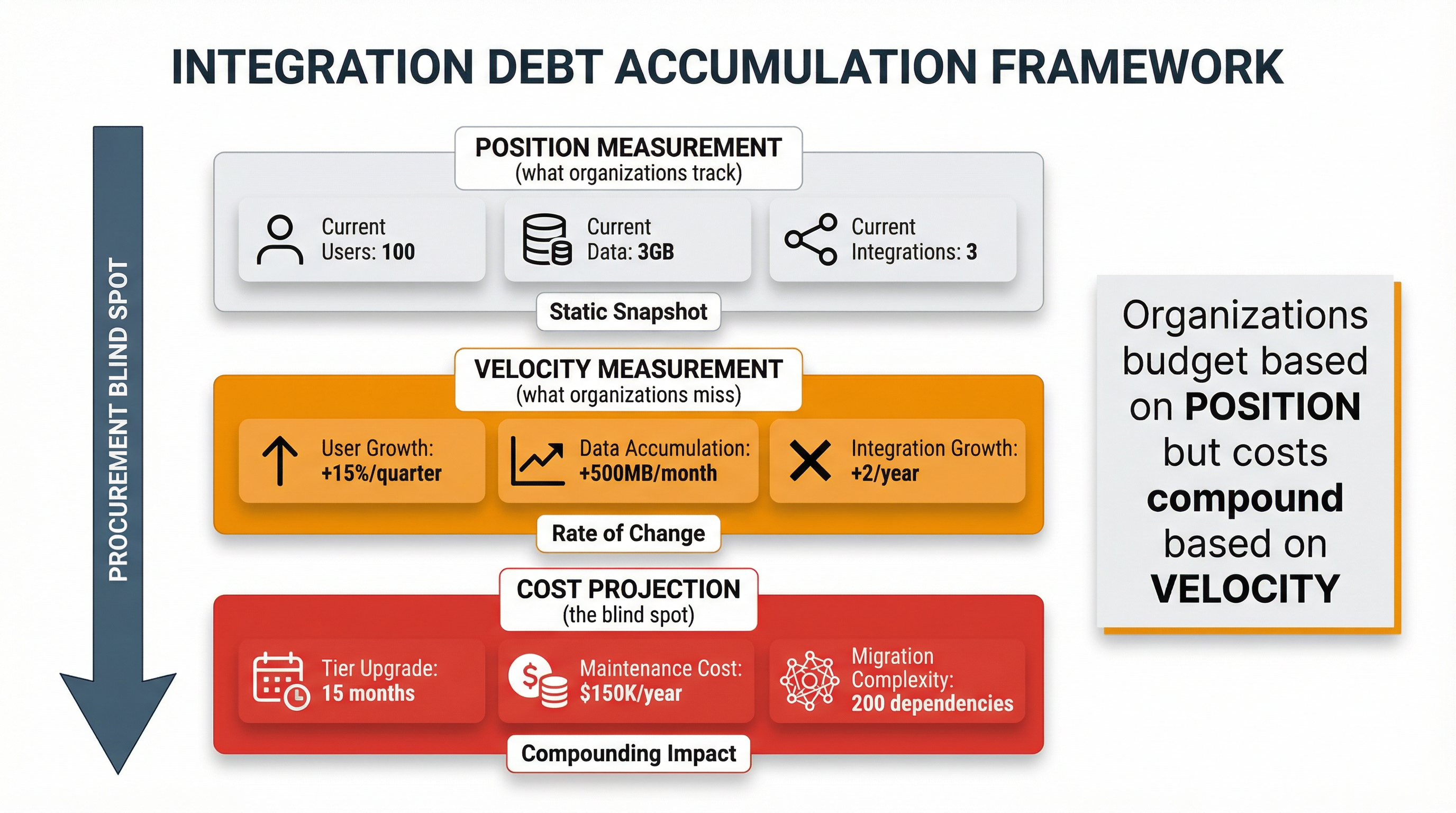

![Integration Debt Accumulation Framework](/images/crm-integration-debt-framework.png)

This maintenance burden stems from factors that aren't visible during initial integration planning. API providers release new versions that deprecate old endpoints, forcing re-integration work. Security vulnerabilities require patches and updates. Rate limits need continuous monitoring and optimization as usage patterns evolve. Data format changes in either the CRM or the connected system necessitate transformation logic updates. Each of these maintenance activities consumes engineering time, and they recur throughout the integration's lifespan.

The compounding effect becomes severe as integration count grows. A company that starts with three integrations and adds two more each year doesn't just add forty percent more integration work—they add forty percent more maintenance surface area that persists indefinitely. By year three, they're maintaining seven integrations, each requiring its own version updates, security patches, and performance optimization. The annual maintenance cost for seven integrations can reach one million dollars or more, dwarfing the original integration development costs.

Organizations that choose custom development over integration platforms face particularly acute maintenance challenges. Custom integrations require developers to write code from scratch, test it thoroughly, and maintain comprehensive documentation. When the original developer leaves, knowledge transfer becomes critical and often incomplete. New team members must reverse-engineer integration logic, understand undocumented assumptions, and navigate technical debt accumulated over years. Research shows that custom integration projects typically rack up substantial costs in ongoing maintenance requirements, security implementation and updates, and infrastructure scaling needs.

The alternative—Integration Platform as a Service solutions—shifts some maintenance burden to the platform provider but introduces its own cost structure. iPaaS platforms operate on subscription models with pricing tied to transaction volume, connector count, or data throughput. A company might pay five thousand dollars monthly for an iPaaS platform, which seems modest compared to custom development costs. But as integration count and data volume grow, iPaaS costs scale accordingly. A platform that costs sixty thousand dollars annually at current usage might cost one hundred twenty thousand dollars annually once the company adds new systems and transaction volumes double.

## Storage and API Consumption: The Velocity Trap

CRM vendors structure pricing around base allocations with overage charges that trigger when usage exceeds included limits. A typical Enterprise tier might include ten gigabytes of data storage, fifty gigabytes of file storage, and one hundred thousand API calls per user per day. During procurement evaluation, these limits appear generous—a company with five thousand customer records and moderate document storage won't approach these thresholds for years.

This analysis treats storage and API limits as static containers. It asks "do we fit?" without asking "how long until we don't?" The failure occurs in measuring position (current usage) without measuring velocity (rate of consumption growth). Storage doesn't remain constant; it accumulates as users upload documents, emails sync automatically, attachments pile up, and historical records age but aren't archived. API calls don't stay flat; they multiply as integrations mature, automation workflows expand, and new tools connect to the CRM.

Consider a financial services firm that implements a CRM with current usage well below tier limits: three gigabytes of data storage, twenty gigabytes of file storage, and thirty thousand API calls daily. Their procurement analysis confirms comfortable headroom. But if document uploads grow at five hundred megabytes monthly (as advisors attach client reports and compliance documents), file storage hits the fifty-gigabyte limit in sixty months. If each new integration adds five thousand API calls daily, and the company adds three integrations per year, they'll exhaust API limits in twenty-four months.

The cost structure of exceeding these limits is where procurement assumptions break down. Additional data storage in enterprise CRM platforms is priced at approximately one hundred twenty-five dollars per month per five hundred megabytes. For a company that exceeds their base allocation by five gigabytes, that's one thousand two hundred fifty dollars monthly, or fifteen thousand dollars annually. To put this in perspective, storing five gigabytes on AWS S3 would cost less than thirty dollars per year—a five-hundred-fold difference. The premium isn't for storage capacity; it's for the convenience of keeping data within the CRM ecosystem rather than architecting external storage solutions.

![Integration Cost Compounding: 3-Year Projection](/images/crm-integration-cost-compound.png)

API limit breaches create even more acute pressure because they directly impact operational workflows. When a company hits their daily API call limit, automated data syncs fail, marketing campaigns can't execute, and support ticket updates stop flowing. The immediate response is often to purchase additional API call packs—recurring add-ons that increase the daily limit for a monthly fee. But if the root cause is integration proliferation (each new tool multiplies API consumption), these add-on packs become permanent line items that compound annually.

The alternative—upgrading to a higher tier—solves the immediate constraint but locks in higher per-seat costs across the entire user base. A company with one hundred users paying forty dollars per seat monthly might upgrade to a seventy-five-dollar tier to resolve API limits. That's an additional forty-two thousand dollars annually, triggered not by needing more users or features but by hitting a consumption velocity threshold that wasn't measured during initial tier selection.

Real-world examples illustrate how quickly these costs escalate. A healthcare company was being charged over forty-five thousand dollars annually in file storage overages due to scanned PDFs stored directly in their CRM. By moving those documents to SharePoint and referencing them with external links, the company reduced its CRM file storage by ninety-two percent and avoided API overages by batching document uploads during off-peak hours. The optimization required upfront engineering work but delivered forty thousand dollars in annual savings—a payback period of less than three months.

The strategic lesson extends beyond storage optimization tactics. Organizations that build velocity measurement capabilities can forecast when they'll hit tier ceilings and budget accordingly. A quarterly review that tracks storage accumulation rates, API call growth per integration, and projected usage against tier limits provides six to twelve months of planning runway. This visibility transforms CRM tier management from reactive firefighting (emergency upgrades when limits are hit) to proactive capacity planning (scheduled upgrades aligned with budget cycles).

## Data Migration: The Complexity Multiplier Nobody Inventories

When organizations evaluate CRM platform switches or consolidations, migration is typically scoped as a data transfer project. Procurement asks "how many records do we need to move?" and "how long will the migration take?" A company with fifty thousand customer records might budget six weeks and fifty thousand dollars for migration, based on estimates from implementation partners who've moved similar data volumes.

Industry data reveals a dramatically different reality. Research across enterprise data migration projects shows that nearly seventy percent fail to meet their objectives, often due to underestimated risks, poor planning, or insufficient validation. Cost overruns frequently exceed fifty percent of original budgets, and project timelines extend by months rather than weeks. A migration budgeted at fifty thousand dollars and six weeks commonly ends up costing seventy-five thousand dollars and taking four months, with another fifty thousand dollars in emergency fixes during the first quarter post-migration.

The disconnect stems from measuring migration complexity by data volume when the binding constraint is actually business process dependency count. A company with fifty thousand customer records might have two hundred distinct business processes that touch customer data: sales workflows that route leads based on customer attributes, marketing campaigns that segment audiences using CRM fields, support ticket assignment rules that reference account hierarchies, and financial reporting that aggregates revenue by customer type. Each of these processes embeds assumptions about data structure, field definitions, and relationship logic.

When migration changes any of these structural elements—renaming fields, consolidating record types, restructuring hierarchies, or altering relationship cardinality—every dependent business process must be inventoried, tested, and potentially redesigned. A seemingly minor change like consolidating "Company" and "Account" into a single "Organization" record type can break dozens of workflows, reports, and integrations that were built around the old structure. The migration team must identify every dependency, assess impact, update logic, and validate that the new structure delivers equivalent functionality.

Organizations that skip this dependency inventory discover breakage in production. Critical reports stop working because the underlying data structure changed. Automated workflows fail because field names no longer match. Integration syncs break because relationship logic is incompatible. Each of these failures triggers emergency troubleshooting, which consumes engineering time and delays other work. The cumulative cost of these post-migration fixes—measured in lost productivity, delayed projects, and emergency consulting fees—often exceeds the original migration budget.

Data quality issues compound migration complexity. Legacy CRM systems frequently contain decades of accumulated inconsistencies: duplicate records, null values in required fields, conflicting data across systems, and records that violate current business rules. A migration that simply lifts this data and shifts it to the new system perpetuates these quality problems and often amplifies them. Research shows that poor data quality leads to compliance failures, incorrect business decisions, and increased manual correction efforts that negate migration benefits.

The mitigation strategy requires treating migration as a data quality remediation project, not just a transfer operation. Organizations must profile their data pre-migration to identify quality issues, cleanse records to meet target system standards, and validate that transformed data maintains business logic integrity. This work is labor-intensive and time-consuming, but skipping it creates technical debt that surfaces as operational friction post-migration.

A particularly insidious risk is data loss during transfer. Even a two percent data loss rate—which might seem acceptable in aggregate—can corrupt critical business processes. If customer segmentation models lose two percent of records, marketing campaigns target the wrong audiences and sales forecasting becomes inaccurate. If financial data loses two percent of transactions, revenue reporting fails audit requirements. The downstream impact of small data loss percentages far exceeds the direct cost of the lost records themselves.

Security and compliance risks during migration create another cost dimension that procurement often underestimates. Data is particularly vulnerable during transit and temporary storage phases. Organizations must encrypt data both in transit and at rest, mask or tokenize sensitive fields during testing, and maintain comprehensive audit trails. For regulated industries (healthcare, financial services, government), migration must comply with GDPR, HIPAA, CCPA, or SOC2 requirements. Non-compliance can trigger legal penalties reaching millions of dollars, while data breaches during migration have ended careers and forced executive resignations.

The operational disruption cost during migration cutover is difficult to quantify but often the most significant. When a company hits a critical data migration failure, operations don't pause while the team troubleshoots. Sales teams can't access customer records. Marketing campaigns can't execute. Support teams can't view ticket histories. The revenue impact of these operational stalls—measured in delayed deals, missed campaign windows, or degraded customer experience—can dwarf the direct cost of the migration itself.

## The Integration Debt Accumulation Framework

Organizations that build visibility into integration cost velocity gain strategic advantages beyond avoiding budget surprises. They can negotiate more effectively with CRM vendors because they understand their own usage trajectories and can structure contracts around projected rather than current needs. They can make build-versus-buy decisions more accurately because they understand the total cost of ownership across their planning horizon, not just initial implementation costs. They can align CRM platform selection with business strategy because they're measuring growth velocity—a strategic metric—rather than just current position.

The framework starts with inventorying every integration touchpoint in the current or planned CRM ecosystem. Beyond the obvious connections to marketing automation, support desk, and accounting systems, catalog data warehouse syncs, business intelligence tool queries, mobile app APIs, webhook-triggered automations, and third-party data enrichment services. Each of these represents an integration that will require ongoing maintenance, consume API quota, and potentially trigger storage growth.

For each integration, estimate annual maintenance burden based on complexity tier. Simple integrations (pre-built connectors with stable APIs and minimal transformation logic) might require twenty hours annually for version updates and monitoring. Moderate integrations (custom middleware with data transformation and error handling) might consume one hundred hours annually. Complex integrations (legacy system connections with brittle APIs and extensive business logic) can require three hundred or more hours annually. At a blended engineering rate of seventy-five dollars per hour, these translate to one thousand five hundred, seven thousand five hundred, and twenty-two thousand five hundred dollars per integration per year.

Project integration count growth based on business roadmap and historical patterns. If the organization has added an average of two new tools per year over the past three years, and each tool requires CRM integration, that's two additional integrations annually. If the roadmap includes new product lines, market expansions, or digital transformation initiatives, integration count might accelerate to three or four per year. This projection reveals the maintenance cost trajectory: starting with three integrations at twenty-two thousand five hundred dollars total, growing to five integrations at thirty-seven thousand five hundred dollars in year two, and seven integrations at fifty-two thousand five hundred dollars in year three.

Measure storage and API consumption velocity by tracking monthly growth rates across each dimension. If data storage has grown from two gigabytes to three gigabytes over six months, that's a fifty percent growth rate, or eight percent monthly. If API call volume increased from twenty thousand to thirty thousand daily over the same period, that's also fifty percent growth, or eight percent monthly. These historical velocities provide baseline projections, though they should be adjusted for known business changes like new product launches or seasonal patterns.

Calculate time-to-ceiling for each constraint by dividing available headroom by monthly growth rate. If the current tier includes ten gigabytes of data storage and the company currently uses three gigabytes growing at eight percent monthly, they'll hit the limit in approximately twenty-two months. If the API limit is one hundred thousand calls daily and current usage is thirty thousand growing at eight percent monthly, they'll hit that limit in approximately fifteen months. The binding constraint—APIs, in this case—determines when the tier upgrade becomes unavoidable.

Compare projected upgrade timing against budget cycles and planning horizons. If the organization operates on annual budget cycles and the binding constraint will be reached in fifteen months, they'll face a mid-cycle upgrade with all its associated friction. If the planning horizon is three years and the binding constraint arrives in fifteen months, they'll experience two unplanned upgrades within the planning window. This projection reveals whether a tier that appears cost-effective based on current pricing will actually deliver value across the intended usage period.

Build migration complexity estimates that account for business process dependencies, not just data volume. Inventory every workflow, report, dashboard, integration, and automation that touches CRM data. For each, assess whether migration will require logic updates, field mapping changes, or process redesign. Categorize dependencies as low-impact (cosmetic changes only), medium-impact (logic updates required), or high-impact (process redesign needed). A migration with fifty low-impact, thirty medium-impact, and ten high-impact dependencies will consume far more time and budget than a migration with eighty low-impact and five medium-impact dependencies, even if both involve the same data volume.

## When Integration Complexity Becomes the Binding Constraint

The strategic implication of integration cost velocity is that CRM platform selection increasingly hinges on integration architecture rather than feature sets or per-seat pricing. Two CRM platforms might offer equivalent functionality at similar per-seat costs, but if one has robust API infrastructure, extensive pre-built connectors, and generous rate limits while the other has brittle APIs, limited connector ecosystem, and restrictive rate limits, the total cost of ownership diverges dramatically over time.

Organizations evaluating CRM platforms should ask fundamentally different questions than traditional procurement checklists suggest. Instead of "what's your per-seat price?" the question becomes "what's your API rate limit structure and how does it scale with tier upgrades?" Instead of "do you offer workflow automation?" the question becomes "what are your integration maintenance requirements and how do API version changes impact existing connections?" Instead of "what's included in your Professional tier?" the question becomes "what's the typical time-to-ceiling for companies with our integration count and growth profile?"

These questions signal to vendors that the buyer understands integration economics and won't be surprised by consumption velocity. Vendors respond by providing more detailed technical specifications, sharing usage data from similar customers, and sometimes offering custom tier structures that better match the buyer's integration profile. The negotiation shifts from "what's your best price?" to "how do we structure a contract that aligns with our integration trajectory?"

For organizations already operating a CRM, integration cost visibility enables proactive optimization. If quarterly reviews show that API consumption is accelerating toward a tier ceiling while storage growth is slowing, the team can audit integrations to identify and eliminate inefficient API usage patterns, consolidate redundant calls through middleware, or schedule non-urgent syncs during off-peak hours. These optimizations extend tier lifespan and defer upgrade costs, but they're only possible when consumption velocity is measured and monitored.

The broader lesson extends beyond CRM to any enterprise software with integration-dependent value delivery. Marketing automation platforms, customer support systems, data warehouses, and business intelligence tools all follow similar patterns: software costs are transparent and predictable, but integration complexity becomes the hidden cost driver. Organizations that build integration debt measurement capabilities for CRM can apply the same framework to their entire software portfolio, transforming procurement from reactive cost management to strategic capacity planning.

Understanding [how CRM systems are structured and deployed](https://flowccrm.com/articles/what-is-crm-software) provides the foundation for evaluating integration complexity, but velocity-based cost modeling transforms that understanding into predictive budget planning. The CRM that fits your current needs is rarely the CRM that fits your integration trajectory, and the cost of discovering that mismatch through budget overruns far exceeds the cost of measuring velocity upfront.

---

**About the Author**: This analysis is based on research across enterprise software integration patterns, SaaS consumption pricing studies, and CRM implementation case studies. The velocity framework presented here synthesizes best practices from IT procurement, financial planning, and software vendor management disciplines.
